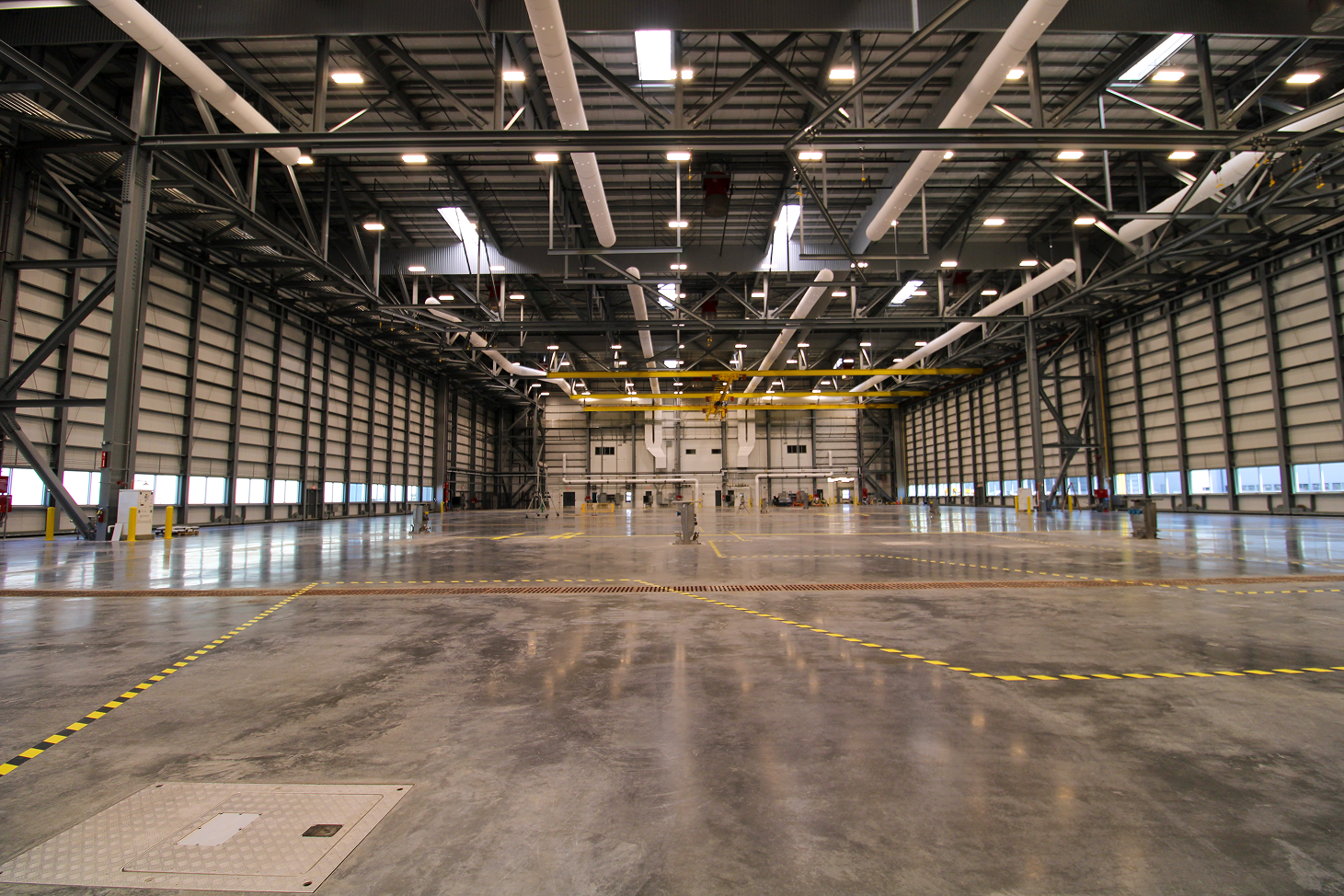

One of the most complex challenges was coordinating the installation of 24 service pits. These pits are critical components that supply power, compressed air, and vacuum essential to aircraft assembly operations.
Early on, JESCO identified these components as critical path items. Daily coordination calls and vigilant tracking were implemented, but fabrication delays significantly affected the slab-on-grade pour schedule.
To keep the project moving, JESCO rescheduled the pour sequence in our master schedule and advanced concrete work out-of-pocket, allowing parallel progress despite missing components. This adjustment required close collaboration with trade partners and the creative use of specialty equipment to support overhead systems before the slab was fully in place.
